SAP Business One production planning: from MRP to production receipt
Order material on time, check delivery dates against capacity, run production orders without spreadsheets. Bills of materials, production orders and material requirements planning are part of the SAP Business One standard.
For detailed scheduling, shop floor data collection and post-calculation, init consulting AG adds beas Manufacturing. The project cost calculator gives you a first estimate for your production.
Production planning and production control in SAP Business One
In the SAP Business One standard, production covers bills of materials, production orders with issue for production and receipt from production, and resources with a daily capacity. The MRP wizard calculates material requirements from orders, forecasts and inventory levels and recommends what to produce, purchase or transfer.
beas Manufacturing is an add-on from Boyum IT Solutions, fully integrated into SAP Business One. It adds routings, planning that calculates material and resource utilisation together, finite capacity scheduling, shop floor data collection, pre- and post-calculation, subcontracting and quality inspection.
Which level a company needs depends mainly on how deep its production structures are and whether machines or staff are the bottleneck.
- Core system
- SAP Business One
- In the standard
- Bills of materials, production orders, resources, MRP wizard, forecasts
- Add-on
- beas Manufacturing, Boyum IT Solutions
- beas manufacturing types
- discrete and process manufacturing
- Database
- SAP HANA or Microsoft SQL Server
- Partner status
- SAP Gold Partner since 2006
All details with sources: fact page on production planning in SAP Business One (in German)
Where production without end-to-end planning costs time and margin
We often hear these patterns in conversations with manufacturing companies. They do not prove that it is the same for you – but they are a good checkpoint.
Material requirements are worked out in spreadsheets
Bills of materials are exploded by hand, stock levels looked up, purchase orders estimated. The result is missing material on the line and excess stock in the warehouse at the same time.
Delivery dates are promised without looking at capacity
Sales commits, production finds out later. At the time of the promise, nobody knows whether the machine is free that week.
Feedback arrives on paper
Job cards and time sheets are typed in at the end of the shift. By the time actual times and quantities are in the system, the order has often been shipped.
What an order actually cost remains unclear
Without feedback per operation there is no plan-versus-actual comparison. Whether an item was produced at the calculated price cannot be answered.
Production and MRP in the SAP Business One standard
For many manufacturers, the standard is the right place to start. Bills of materials, production orders and planning use the same items, warehouses and documents as purchasing and sales.
Bills of materials
Four types: production, assembly, sales and template. Bills of materials contain items and resources and can have several levels. Phantom items represent sub-assemblies that are not kept in stock.
Production orders

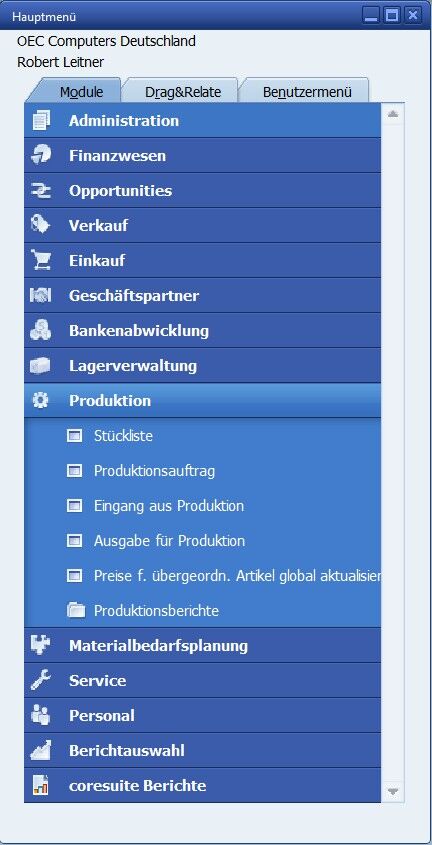

As standard, special or disassembly orders. An order moves through the statuses planned, released and closed; components can only be issued once it has been released.
Issue and receipt from production
Components are issued manually or by backflush. With the receipt from production, the finished product goes into stock and SAP Business One calculates the production cost of the order.
Routes with stages
A production bill of materials can be divided into stages. Each stage is issued and reported separately in the production order; the system calculates dates forwards or backwards against resource capacity.
Resources and capacity
Resources of type machine, labour or other, each with a daily capacity. The capacity overview compares available, committed and consumed capacity and shows where a resource is overloaded.
MRP wizard
Several planning scenarios, also for playing through what-if cases. Takes forecasts, minimum order quantity, order multiples, lead time and minimum and maximum stock into account. The documents are created from the order recommendation.
This description follows the SAP SE learning units on logistics and production in SAP Business One (SAP Learning) and the SDK database reference. Individual sources are listed on the fact page (in German).
beas Manufacturing: production control for SAP Business One when the standard is no longer enough
beas Manufacturing from Boyum IT Solutions is fully integrated into SAP Business One. No data is held twice and no interface files are needed. The functions below are described in the manufacturer's online help.
Production master data
- Routings made up of operations, internal or external
- multi-level bills of materials with a structure depth of up to 20
- resources as work station, personnel group or machine
Work orders
- positions with all items produced in the order
- routing per position with an assigned resource
- subcontracting: order external work as a service, provide the material
Planning
- its own material requirements planning in beas
- MRP II: material and resource utilisation calculated together in one scenario
Finite scheduling (APS)
- schedule orders against the capacity that is actually available, from the start date or backwards from the delivery date
- machines with a capacity limit set are not overbooked
- graphical display of the order flow as a Gantt chart
Shop floor data collection
- report times and quantities directly from the shop floor
- on a touch terminal next to the machine, on a tablet or smartphone
Costing
- pre-calculation for quotations on products that have not yet been manufactured
- post-calculation: plan against actual, on a marginal and on a full cost basis
- work in progress is held on a dedicated WIP account
Traceability
- batch tracing across every single transaction
- serial number tracing
Quality assurance
- inspection plans for quality control
- approval by the four-eyes principle, with an electronic signature if required
Variants and product configurator
- any number of configurations instead of one bill of materials per combination
- a multi-level work order is created directly from a variant
Integrated into SAP Business One
- add-on: it does not run without a licensed SAP Business One
- runs on SAP HANA and on Microsoft SQL Server
- web applications for smartphone and tablet as well
- finite scheduling (APS) is a separately licensed module
When beas Manufacturing pays off
When routings with many operations are maintained, machines are the bottleneck and dates have to be scheduled against finite capacity, when times are to be reported directly from production and orders are to be post-calculated. Companies that manufacture in a single level or in simple series often manage with the standard.
Manufacturer information: beas Manufacturing at Boyum and the beas Manufacturing online help.
Standard or beas Manufacturing: what each is designed for
A first classification. The decision depends on the depth of your bills of materials and routings, on your bottlenecks and on how precisely you want to post-calculate orders.
| Task | SAP Business One standard | With beas Manufacturing |
|---|---|---|
| Structure the product | four bill of materials types, multi-level, phantom items | multi-level bills of materials up to structure depth 20 |
| Describe operations | routes with stages in the production bill of materials | routings with internal and external operations |
| Calculate requirements | MRP wizard with scenarios, forecasts and order recommendations | MRP II: material and resource utilisation together |
| Plan capacity | daily capacity per resource, capacity overview, scheduling forwards or backwards | finite capacity scheduling, Gantt display |
| Report production | issue for production and receipt from production, manual or backflush | shop floor data collection for times and quantities at the terminal or on mobile devices |
| Determine costs | production cost at receipt from production | pre-calculation, post-calculation with plan and actual, work in progress |
| Subcontracting | – | order external work as a service, provide the material |
| Configure variants | – | product configurator, orders directly from the variant |
| Inspect quality | – | inspection plans, four-eyes principle, electronic signature |
“–” means: not described in the SAP SE learning units on production on which this page is based. Boyum lists these functions as part of beas in its own comparison. Whether some of them can be covered with SAP Business One on-board tools is something we clarify in a conversation.
Which level suits which kind of production
Three typical starting points from our consulting practice. Your production may sit in between; then the bottleneck decides.
Simple structures, predictable series
Few bill of materials levels, hardly any operations, material is the bottleneck. Here, bills of materials, production orders and the MRP wizard in the standard often go a long way.
Machines are the bottleneck
Dates depend on the loading of individual machines, orders compete for the same resources. Then finite capacity scheduling and feedback from production pay off.
Make-to-order and variant production
Customer-specific versions, subcontracting, post-calculation per order. This is the field of beas Manufacturing – for example in plant and machine construction.
From the cost calculation to running production
init consulting AG provides consulting, implementation, training and support from one source – for SAP Business One and beas Manufacturing.
Calculate project costs
In the online calculator you answer a few questions, starting with your industry, and receive an initial project estimate.
Analysis of your production
Bills of materials, routings, bottlenecks, feedback and costing as they run today. This shows whether the standard is sufficient or beas Manufacturing is added.
Concept and quotation
You receive a quotation with licences, implementation and training – with the modules your requirements justify, no more.
Implementation and testing
Master data, bills of materials and routings are migrated and tested with real orders before production switches over.
Training and operation
Planning, production control and accounting are trained for their role, including beas. After that we remain your point of contact: ticket support, hotline, remote access and version upgrades.
What production planning in SAP Business One does not do
We would rather answer these points here than in the first meeting.
beas Manufacturing is an additional product
It is not part of the SAP Business One standard, requires an SAP Business One licence and is licensed separately. The manufacturer is Boyum IT Solutions.
Finite scheduling is a separately licensed module
Scheduling against finite capacity (APS) extends the capacity planning of beas and is licensed separately. Whether you need it depends on your bottlenecks.
The standard does not plan without capacity
SAP Business One also spreads route dates forwards or backwards across the available resource capacity. What is missing is detailed scheduling with graphical loading – that is where beas comes in.
The beas web client is still catching up
According to Boyum, release 2026.09 brings the web client closer to the desktop client, but it is not yet equivalent. We check which functions you need in the browser before we quote.
Process manufacturing needs to be clarified in detail
Boyum names beas for discrete and for process manufacturing. How recipes, co-products and by-products are mapped for you is something we clarify using your actual product.
No post-calculation without feedback
Post-calculation only shows what has been posted. If times are only entered at the weekend, the plan-versus-actual comparison remains inaccurate – with any software.
Terms used on this page
- Bill of materials
- List of all components and quantities from which a product is manufactured. In SAP Business One it can contain resources as well as items.
- Production order
- Document that triggers the manufacture of a quantity of a product. It controls the issue of components, feedback and the receipt of the finished product.
- Material requirements planning (MRP)
- Calculation of which material is needed when and in what quantity, based on orders, forecasts and stock. The result is recommendations for production and purchasing.
- Finite scheduling (APS)
- Advanced Planning and Scheduling. Loading operations onto resources while respecting their limited capacity.
- Shop floor data collection
- Reporting times and quantities directly from production, for example at a terminal or on a tablet. In German: Betriebsdatenerfassung (BDE).
What manufacturers want to know about production planning in SAP Business One
Can SAP Business One do production planning in the standard?
Yes. The standard includes bills of materials, production orders with issue for production and receipt from production, resources with a daily capacity and the MRP wizard, which derives from orders and forecasts what needs to be produced, purchased or transferred.
When is the standard enough, and when do we need beas Manufacturing?
The standard is often enough for simple structures and predictable series, when material is the bottleneck. beas Manufacturing pays off when routings with many operations, finite capacity scheduling, feedback from production or post-calculation per order are needed.
What is beas Manufacturing?
An add-on for manufacturing, developed by Boyum IT Solutions and embedded directly in SAP Business One. It brings routings, planning that also calculates machine utilisation, finite scheduling, feedback from the shop floor, pre- and post-calculation, subcontracting, batch tracing and quality inspection.
Does SAP Business One plan with machine capacities?
Yes, within limits. Resources have a daily capacity, and for routes SAP Business One spreads the dates forwards or backwards across the available capacity. Detailed scheduling with graphical loading and finite capacity is offered by beas Manufacturing with the APS module.
Can employees report times directly from production?
With beas Manufacturing, yes. Employees report times and quantities via shop floor data collection, according to the manufacturer also in the browser on touch terminals, tablets and smartphones.
What does production planning with SAP Business One cost?
The costs consist of licences, implementation and training and depend on whether the standard is enough or beas Manufacturing is added, how many users need which licence and whether you run the system in the cloud or on premises. The project cost calculator gives a first estimate; prices for SAP Business One are on the prices and costs page.
Does beas Manufacturing run on SAP HANA and SQL Server?
Yes. In its installation guide, the manufacturer describes the same procedure for both databases. An SAP Business One licence is required.
Who supports us after the implementation?
The same team that carried out the implementation. init consulting AG offers ticket support, a telephone hotline and remote access as well as ongoing maintenance and version upgrades. Go to support
